June 2026

12.06.2026
  • The monolithic frame, vertical waterproofing, and backfilling of the excavation pits for Phase 1 of section 1.1 and parking lot #1 have been completed. The excavation for parking lot #2 has been prepared, and masonry for Phase 1 of section 1.1 has been laid.
  • Installation of sewage risers, erection of vertical structures for parking lot #2, the monolithic frame for Phase 1 of parking lot #3, and the laying of electrical networks for the apartments are nearing completion.
  • Horizontal waterproofing of the foundation for parking lot #2 is currently underway.
  • Work has commenced on the frames of sections 1.2 and 1.3, involving the erection of vertical structures for the 1st floor.
    Installation of window and aluminum structures is underway on the 2nd floor of section 1.1.

Детальніше

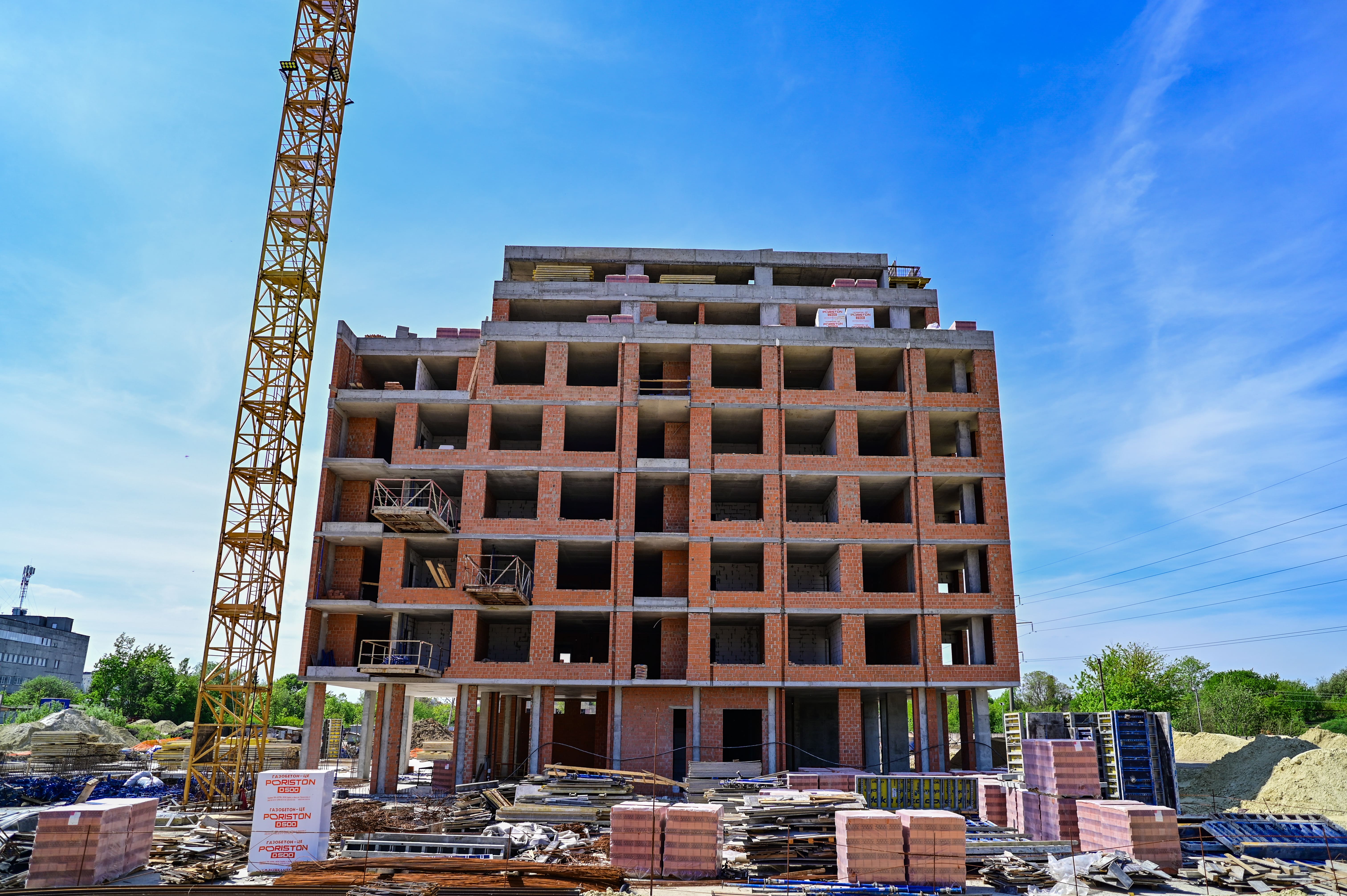

May 2026

14.05.2026

The construction of the pit of the 1st phase of construction has been completed

The installation of the monolithic frame of the 1st stage of the parking lot has been completed

Section 1

Installation of the monolithic frame of the 1st stage of section 1.1- work completed by 95%

Masonry of the 1st stage section 1.1 - 70%, work is carried out on 6-7 floors

Installation of a monolithic frame of section 1.2-1.3 - work has begun on the installation of vertical structures of the plinth

Детальніше

April 2026

14.04.2026

Construction of the excavation of the 1st phase of construction — 70 percent completed.

Arrangement of a monolithic frame of the 1st stage of the parking lot - work is being carried out on the reinforcement of the floor slab.

Section 1:

Installation of monolithic frame section 1.1 — completed by 90%, work is being carried out on vertical structures on the 8th floor.

Masonry section 1.1 — 60% completed, works are carried out on 5-6 floors.

Installation of vertical waterproofing of section 1.1 — 80% completed.

Arrangement of filling the sinuses of the excavation section 1.1 — completed by 70%.

Section 2:

Arrangement of the pile field section 2.1 - work started on the installation of test piles

Детальніше

March 2026

13.03.2026

Section 1.2-1.3

  • Construction of the pit -80%

Section 1.1

  • Installation of waterproofing -80%
  • Construction of the frame of the building —90%
  • Installation of masonry -20%
  • Installation of ventilation units -20%

Section 2.1

  • Construction of the pit -100%

Parking 3

Foundation installation -90%

Детальніше

February 2026

13.02.2026

Section 1

Installation of vertical waterproofing of the plinth is completed

Arrangement of the floor slab of the 5th floor of section 1

Construction of the pit section 1.2, 1.3

Детальніше

Januar 2026

15.01.2026

Installation of vertical waterproofing of the plinth

Arrangement of the floor slab of the 3rd floor of section 1

Completed work on the construction of the pit section 2

Arrangement of concrete preparation of section 1

Детальніше

Contacts

Sales Department, Lviv

Staryi Rynok Square, 8
+38 (067) 837 00 22sales@intergal-bud.com.ua
Directions

Address of the object

Zoryana Street, 39
Plot a route

Free consultation

Дякуємо!
Ваша заявка отримана
Упс, нажаль щось пішло не так
